STARDUST
Satellite for Tracking And Research of atmospheric Dust Using Spectroscopic Techniques
Characterizing the Cosmic Dust and Space Debris Environment in Low Earth Orbit
Version: I01
Reviewed by: Mathieu Udriot and Marnix Verkammen
Review date: 30/04/2026
Review status: ✅DONE
The following contains all the relevant informating resulting from this study, from the context and mission objectives to lessons learned.
For a list of terms and acronyms often used, check the Glossary section.

This study was performed at eSpace Concurrent Design Facility by the following team:
| Name | Affiliation | Role |
|---|---|---|
| Udriot Mathieu | External lecturer | Facilitator |
| Verkammen Marnix | External lecturer | Facilitator |
| Hellmich Stephan | eSpace | Facilitator |
| Feyzi Abdullah | eSpace | Facilitator |
| Sterken Veerle | eSpace | Customer |
| Hosoyamada Makoto | EPFL | Attitude & Orbit Control (AOC) |
| Jorand Hugo Téo | EPFL | Communications & Data Handling (CDH) |
| Boisel Rafaël Jules Valentin | EPFL | Propulsion |
| Cvetkovska Melani | EPFL | Structure and mechanism |
| Guasch Mesià Enric | EPFL | Systems Engineering |
| Heeb Ramon | EPFL | Trajectory analysis |
| Van Der Kuyl Jan Alexander | EPFL | Trajectory analysis |
| Maalouf Rayane | EPFL | Sustainability |
| Sánchez-Moreno Royer Pedro | EPFL | Power |
| Sivakumar Briyan | EPFL | Configuration |
| Truchot Antoine | EPFL | Thermal |
AI tools were used in this report, following the EPFL guidelines for using (Gen)AI in studying.
Claude / ChatGPT were used to improve writing, getting feedback on report completeness (guidelines comparison), generate the title page and table of contents, and re-factor section titles.
Background: This study took place within the ENG-411 Concurrent Engineering course given through the Space Technologies minor at the EPFL. Presented by customers Veerle Sterken and Stephan Hellmich, it addresses the growing environmental challenges posed by space debris and cosmic dust and serves as a learning opportunity for students to apply concurrent design principles.
Objective: With the launch of over 1,750 tons of payloads in 2025 alone [1], the orbital environment has become increasingly congested. Current data suggests that satellite re-entries now inject more metals into the Earth's atmosphere than natural meteors, highlighting the need for in situ measurements to refine atmospheric models and understand these anthropogenic impacts.
Scope: The mission scope involves a Phase 0/A conceptual design for a satellite system able to deploy two payloads. The spacecraft will be equipped with a Time-of-Flight Mass Spectrometer and a piezoelectric dust counter, capable of measuring the flux, chemical composition, and orbital parameters of (sub)-micrometer-sized particles. The system will deliver data for understanding the anthropogenic metallic influx into Earth's atmosphere and the temporal and spatial variability of the cosmic dust and space debris environment.
The mission aims to characterize the cosmic dust and space debris environment in Low Earth Orbit. To fulfill its scientific goals, the spacecraft is designed to orbit up to 2,000 km, operate for a minimum of five years, launch on a European vehicle, and remain within a 170 M€ budget cap.
The key design drivers and constraints identified prior to the study were the harsh radiation environment at the target orbit, the high ΔV demand imposed by the trajectory, the scientific requirement for continuous measurements, and the programmatic constraints of a European rideshare launcher.
The study developed the full preliminary mission architecture through a concurrent engineering process, covering all major subsystems.
The final design is launched into orbit by an Ariane 62, operates in a Sun-Synchronous Orbit (SSO) from 500 km to 2,000 km over the mission duration of 5 years, and successfully closes all mass, power, and cost budgets within their allocated margins. It also confirms post-mission disposal in compliance with ESA debris mitigation guidelines within the five-year goal.
Systems Engineering owns the top-level mission envelope and ensures that every subsystem decision remains consistent with the customer statement. The flowed-down requirements are grouped into three themes: mission-level / programmatic constraints, science flow-down, and operational envelope.
Mission-level and programmatic:
Science flow-down:
Operational envelope:
The mission is organized into five phases over approximately 5.25 years, as summarized in Figure 1 and Table 2. Ascending and descending science share a single continuous low-thrust spiral; the payloads never stop acquiring except when thrust arcs would contaminate the measurement (REQ-33).

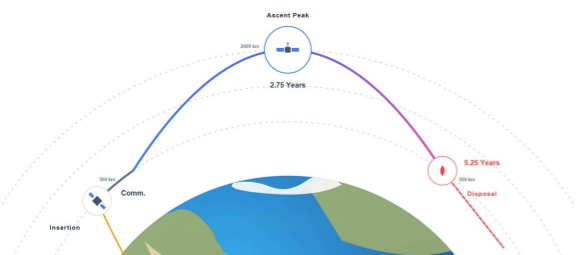

Figure 1 CONOPS — Altitude profile and mission phases for STARDUST (rideshare insertion at 500 km, ascent to 2000 km, descent, and disposal at 5.25 years).
| Phase | Altitude | Duration | Primary activity |
|---|---|---|---|
| Launch | 0 → 500 km SSO | Hours | Rideshare injection into dusk–dawn SSO |
| Commissioning | 500 km | ≤ 3 months | Deploy, checkout, first-light |
| Ascending Science | 500 → 2000 km | ~2.75 yr | Primary survey; continuous low-thrust raise |
| Descending Science | 2000 → 500 km | ~2.25 yr | Extended survey; low-thrust descent |
| Disposal | 500 → 300 km | ≤ 6 months | Propulsive descent, passivation, natural re-entry |
Table 1 Mission phases, altitude profile, and duration.
Five on-board modes cover the full life cycle: Activation (commissioning), Payload Acquisition (nominal science, ram-pointing with Sun/Earth avoidance), Downlink (S-band TT&C and X-band science), Autonomous Safe (Sun-pointing, ≥ 72 h without ground contact per REQ-44), and Passivation / End-of-Life.
The mission risks were identified and categorized into three families. Environmental risks (ENV) cover external hazards inherent to the orbital environment. Hardware risks (HW) address failure modes internal to the spacecraft, the most critical being permanent blinding of the TOF-MS sensor. Project management risks (PM) capture programmatic uncertainties around cost and schedule.
Following mitigation, all risks are reduced to medium or low residual severity, with no high-severity risks remaining.

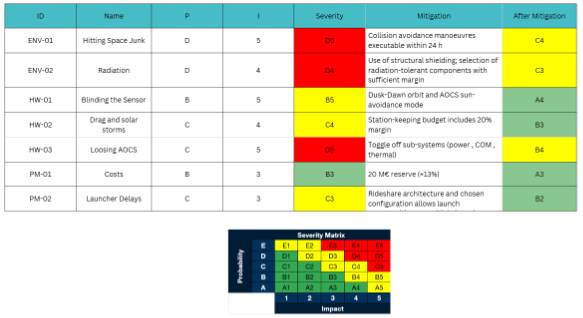

Figure 2 Risk Assessments Matrix
Acting as the Systems Engineer for STARDUST highlighted a handful of lessons that transcend the individual subsystems:
The Trajectory Analysis section is responsible for the selection of the trajectory that most optimally suits the overall mission goals while still conforming to the requirements of all other subsystems. The specific requirements are thus as follows:
Assumptions were made to allow for refinement of overall mission goals and thus to start the process of selecting an orbit. The key assumptions were that this mission had a 5-year operational lifetime at minimum and that the dust and debris the mission seeks to explore orbit largely prograde over a range of inclinations.
Our key considerations when determining a suitable trajectory for this mission, as defined in the science goals of this mission, were first to maximise dust flux through the sensors and to analyse the time variance and location variance of this dust. After further discussion with the customer, we agreed to focus experimental time at altitudes less than 1000km, especially below 800km as these were prioritised, and ideally to explore dust in regions of space which were novel for dust exploration satellites. To meet all the drivers, it is imperative that the velocity of the spacecraft relative to the inbound dust and debris was maximised. The required thresholds are seen in Figure 3, with our goal to have a high probability of achieving relative velocities above 10m/s for more than half of every orbit, and to prioritise metal elements from the list of potentials, also described in Figure 3.

Figure 3 - Necessary relative velocities required for the spectrometer to achieve readings for dust of a given chemical makeup (taken from Customer Specifications).
Considering the science requirements, the internal requirements from each respective subsystem and the design drivers and assumptions, we established two possible trajectories for the mission.
The first orbit proposed was a highly eccentric retrograde orbit, like the Molniya orbit first used by Russian Geoscientists as an alternative to GSOs. After launch and initial commissioning, we would inject, via kickstage or otherwise, into a highly elliptical orbit with a perigee altitude of approximately 400km, and an apogee of approximately 36000km. Over the course of the first half of the mission, the spacecraft would partially circularise the orbit to raise the perigee, until the perigee was 3000km after a mission elapsed time of 2.75 years. Following this, the spacecraft would then undo this partial circularisation and would reduce the perigee to 400km after a mission elapsed time of 5.25 years. The spacecraft would then enter an end-of-life phase and deorbit. A visualisation of the orbit can be seen in Figure 4.

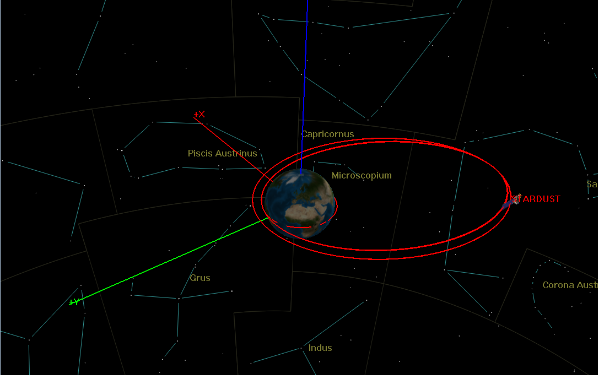

Figure 4 shows a GMAT simulation of the first proposed orbit. We can observe that the spacecraft starts in a retrograde circular orbit, before transferring via a kickstage into a highly elliptical orbit with an apogee altitude of 36,000km. Then over 2.5 years, the perigee is raised to 2000km. It is noted that the many small transfer orbits between the initial orbit and the maximum orbit reached are not shown, so the plot does not become cluttered.
Advantages
Disadvantages

Figure 4 - Retrograde Molniya Orbit Simulation
The second orbit proposed was a circular dusk-dawn SSO, again involving an element of orbit raising and degrading to achieve the mission goal of understanding the space and time variance of atmospheric dust. The trajectory starts at 400km and follows a spiral trajectory as the orbital altitude is raised slowly to 2000km after initial commissioning, performing inclination change maneuvers where required to maintain SSO. This maximum altitude is reached after a mission elapsed time of 2.75 years before the altitude is then decreased back to 400km for the remainder of the mission. Following this, an end-of-life stage is entered, and the spacecraft is set on a burn-up trajectory. A simulation of this trajectory can be seen in Figure 5 and 6.
Figures 5 and 6 show the simulated results of the second proposed trajectory, highlighting the spiral nature of the orbit. It is further noted that the orbits would change in much smaller increments during the real mission, but to more easily visualise the spiral effect larger steps between orbits were taken. Also, while difficult to observe, Figure 5 shows the inclination changes required as the orbit is raised to the maximum altitude. It is noted here that the yellow axis denoted ‘+S’ shows the direction of the Sun with respect to Earth.
Advantages
Disadvantages

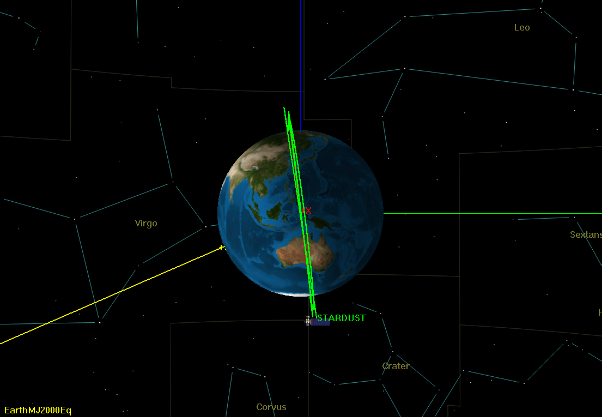

Figure 5 - GMAT Simulation of Circular Dawn-Dusk SSO Trajectory (View into X axis)

Figure 6 - GMAT Simulation of Circular Dawn-Dusk SSO Trajectory (View along Y axis)
Based on the tradeoff outlined above, we selected the Circular Dusk-Dawn SSO. The orbit allows us to fulfill all of our objectives and should result in a significantly cheaper mission compared to the Molniya orbit. This is mostly due to the constant power provided by the sun and the limited eclipses in this type of SSO. Additionally, it is also easier and cheaper to reach by a launcher than the Molniya orbit.
Orbital Parameters of Deployment Orbit

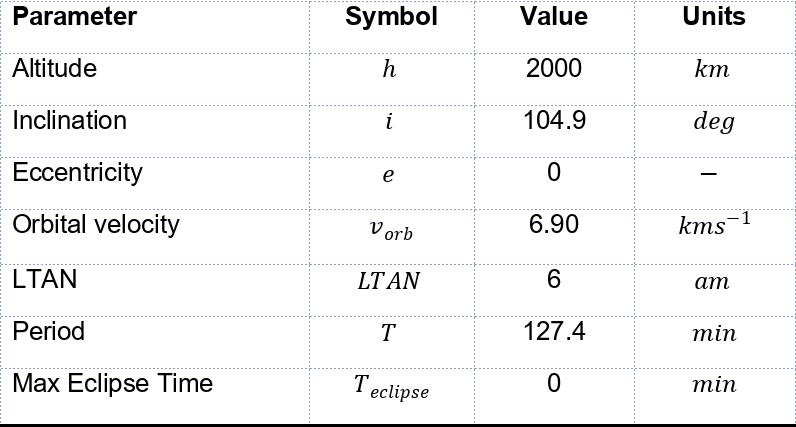

Orbital parameters of Highest Orbit

The spacecraft is deployed into a 500x500 km Dusk-Dawn SSO by the launcher. Throughout the mission we continuously raise our orbit until we reach a 2000x2000 km orbit. At this point we turn the spacecraft around and lower our orbit back to a 500x500 km orbit. Once an altitude of 500km is reached, we continue to lower our trajectory until we reach an altitude of 300 km and can safely burn up the satellite in the atmosphere. A detailed illustration of our CONOPS can be seen in Figure 1 within Section 3.1 of the System Engineering Section. The orbital parameters of our deployment and highest orbit can be seen in the tables in sections 3.1.1 and 3.1.2 respectively.
The mission is constructed in a way that allows us to collect scientific data at any given time. As you will see in Section 3.5, we achieve the required 10 km/s relative velocity to the average particle throughout every mission stage.
The selected orbit brings with it some challenges that need to be addressed. Firstly, we made the decision to stay in an SSO for the entire duration of the mission. Since the required inclination for an SSO changes with altitude, we also need to change our inclination while raising and lowering the orbit. We believe that the decreased eclipse frequency and duration in a Dusk-Dawn SSO contributes to large cost and complexity savings for the thermal and power subsystem. These projected cost savings would outweigh the projected increase in propellant needed to change the inclination.
Throughout the mission, we would therefore change the orientation of the satellite while crossing the equator to provide the necessary change in inclination. Once we have reached an altitude of 2000 km, we turn around the satellite and use our thruster to lower the orbit. This also necessitates a 180-degree rotation of our payload as it needs to be kept pointing in flight direction.
The first calculations performed were a series of standard calculations for circular orbits to define required orbital parameters:

Where in the case of SSO, the required nodal progression is 360 degrees per year to match the rotation of the Earth.
Rearranging the nodal regression equation considering the nodal regression needed for SSO and the desired orbit altitude, we get the following expression for orbit inclination where all parameters have their standard meanings.
As we raise our altitude up to an altitude of 2000km from 400km, before reducing back down again, the total delta-v required to maintain SSO over the mission duration is defined below:

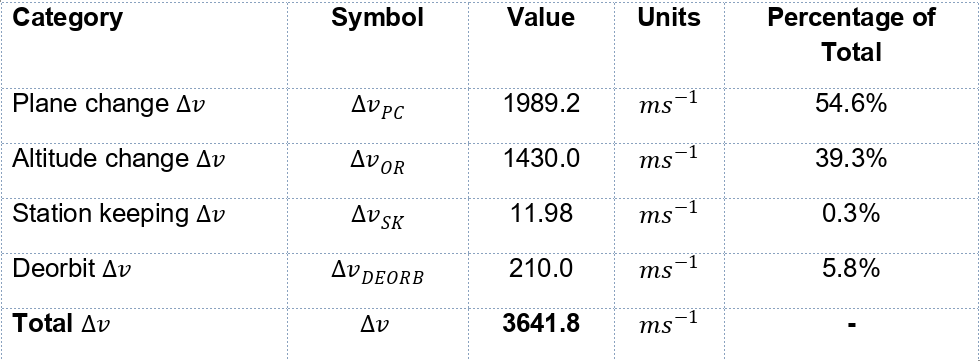

Where {Delta v_pc} defines the total delta-v required for all the plane change maneuvers during the mission.
The delta-v required to change the altitude of the orbit was approximated as a sequence of small Hohmann transfer steps between the minimum and maximum altitudes. For small altitude changes, this converges to the delta-v required for a continuous low-thrust spiral:

Where the above calculation includes both burns of the Hohmann transfer and {Delta v_or} defines the total delta-v budget for all altitude change burns during the mission. This equation was solved using a python simulation to sum over calculated Hohmann transfer for orbits with 1km steps.
The station keeping budget was derived from literature for spacecraft of our size, given the different orbits the spacecraft will spend time in. As can be seen in section 3.8, these final values were negligible with respect to the delta-v budget required for other maneuvers. Hence, these calculations need not be over scrutinized:
![]()
Where {Delta v_sk, altitude} defines the total delta-v required to maintain an orbit at a given altitude, and {t_altitude} defines the total time spent at a given altitude during the mission. Above 1000km, the station keeping budget becomes negligible for our mission.
Knowing the worst-case eclipse duration is an important consideration in the design of thermal subsystem as well as for the sizing of the battery. Additionally, knowing the total amount of eclipses allows for further refinement of battery size. The calculation of these parameters is outlined below.
Eclipse duration
For calculating the worst-case duration of an eclipse throughout the mission we first need to know two parameters. The beta-angle denotes the angle between the orbital plane and the sun vector. A lower beta angle means that the expected eclipses are longer. Since we are in a Dusk-Dawn SSO, we know that the lowest beta angle throughout the mission happens during winter solstice. At that moment the axis of the earth is tilted away from the sun by 23.45 degrees. Additionally, the inclination of our lowest orbit of 96.66 degrees leads to the orbital plane being tilted to a further 6.66 degrees when compared to the earth’s axis. This is visualized in Figure 3.5.1 below.

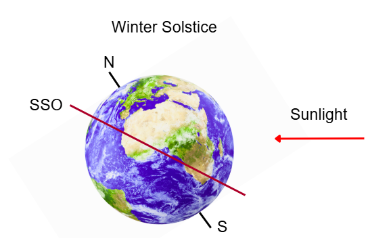

Figure 7: Worst-case scenario for eclipse duration
This leads to a total tilt of 30.11 degrees which when subtracted gives us a beta-angle of 59.89 degrees. The reason that we use the inclination of our lowest orbit is that for SSO’s the eclipses are longer the lower the altitude. This is symbolized by the second required parameter, the earth angular radius theta. It is calculated using the formula below, where R is the earth’s radius and a is the semi major axis of the orbit. The value of theta for an orbit with an altitude of 300 km, which is the lowest altitude encountered during the mission, is 72.75 degrees.

Using the values calculated above, we can calculate phi by using the formula below. Phi denotes the angular radius of the orbit that encounters an eclipse in degrees. By dividing it by 360 we get the fraction of the orbit spent in eclipse. Multiplying the fraction by the orbital period finally yields the eclipse duration. For our mission, the longest eclipse will have a length of 27 minutes.

Total number of Eclipses
To calculate the total number of eclipses throughout the entire mission, we used approximations. Further refinement would be needed to achieve a more accurate number. However, we are confident that our values end up in the correct ballpark.
By varying the beta angle and observing the eclipse duration with the formula above, we noticed that the minimal beta angle where eclipses would appear was 72.7 degrees at an altitude of 300 km.

In the above formula Γ denotes the ecliptic true solar longitude, Ω the RAAN, i the inclination and ε the obliquity of ecliptic of earth. By varying the RAAN and the ecliptic true solar longitude we were able to determine that the beta angle is below 72.7 degrees on 150 days around the winter solstice.
We also noticed that for any given beta angle, we would not have any eclipse above an altitude of 1000 km. We then proceeded by making simplifying assumptions. Namely we assumed that the transfer from 500 km to 1000 km as well as the lowering of the orbit from 1000 km to 300 km would take 2 years in total. Additionally, based on the calculations of the orbital period, we assumed that the average amount of orbits per day in those timespans would be fourteen. Therefore, solving 14 * 150 * 2 amounts to 4200 eclipses. Since we made quite some assumptions for this calculation, we included a big margin and rounded that up to a total of 5000 eclipses throughout the entire mission.
Relative velocity was calculated with:

Where θ is the angle between the satellite velocity vector and the dust velocity vector, assuming a simple Earth-Centered Inertial (ECI) frame with a planar approximation for considering the average case. More explicitly, we consider:

Please refer to the sustainability section where the exact strategies are detailed.
The delta-v values for the end-of-life stage are outlined in section 3.8.2 and include the necessary delta-v to maintain SSO and to reduce altitude to the desired levels, in the desired timeframe, again as outlined in the sustainability section.
Please see the tables in Section 3.1.1 and 3.1.2 for the orbital parameters of the initial and highest orbits.

The assumptions made during trajectory selection were highlighted in section 2.1, and those made during calculations and simulations can be found in their respective sections.
As seen in section 3.4, the delta-v calculations for orbit altitude raising and reduction and plane change maneuvers were done separately and then combined. We recognised that we could likely reduce our delta-v budget by combining these maneuvers. However, given the timeframe of this CDF and the implications that a large change to the total required delta-v could have on other subsystems, we opted to not further refine these calculations.
Another area which we are aware could have been investigated more rigorously was the relative velocity calculations. As seen in section 3.6, these were modeled assuming a simple ECI frame with a planar approximation, to reduce this to a 2D vector problem. We took the dust to be orbiting around the equator (i=0) to represent the average-worst case for the dust impact velocities with respect to the spacecraft. Simulating the spacecraft’s orbit with known current dust data would allow for better calculations in this case.
Furthermore, the station-keeping delta-v budget was derived from literature and given a 20% margin, and so could be refined given the final dimensions, mass and trajectory of the spacecraft. However, as seen in section 3.8.2, we note that the derived station keeping delta-v budget constitutes a minimal part of the total delta-v budget, and so improvements to this value are unlikely to make a significant difference.
The calculations for the burns required to raise altitudes were modelled as a series of very small Hohmann transfers, to achieve the spiral orbit and to allow for the use of low impulse, high ISP thrusters that could reduce the necessary propellant tank size onboard the spacecraft. While, from literature, we can assume that this approach is valid, we highlighted this as an area with potential improvement should there be maneuvers more suited to an orbit of this nature.
It’s also possible that our assumptions with regards to the orbit distribution of dust and debris are largely different than anticipated and thus a slightly different orbit would better suit a specific type of dust present in orbit around the Earth.
We anticipate that the largest area of refinement would be improving the delta-v calculations. If every plane change maneuver was combined with every altitude increase/decrease maneuver, we expect that the total delta v required for the mission would reduce.
Similarly, carrying out more advanced simulations of the spacecraft to determine more accurate measurements for dust impact velocities would be beneficial to improve the trajectory selection of this mission. This could be done using full 3D velocity vectors in the Earth-Centered Inertial frame, accounting for orbital inclinations, eccentricities and a statistical distribution of approach angles through Monte Carlo simulations.
There were many major learnings that we had throughout the engineering sessions.
The first one was the complexity of selecting the correct trajectory for the mission. Initially, we assumed that the trajectory design for an earth orbit mission would be quite simple compared to a lunar or interplanetary spacecraft. However, the nature of our science-driven trajectory with the additional constraint of sufficient relative velocities made our choice quite complex. Maximizing the scientific potential of the mission was an even bigger challenge than calculating all the required parameters for the selected mission profile. This is certainly not something that we expected and made us appreciate the challenges that come with balancing scientific interest and mission feasibility and cost even more.
Our second lesson learned concerns the concurrent engineering aspect of the course. Throughout all sessions, we functioned as drivers for mission objectives. We were the team that translated the scientific requirements into something tangible that could be built upon by the other subsystems. As such, communication becomes even more crucial for us than for other subsystems as our decisions have an impact on all the other teams. And while we generally did a good job keeping everyone up to date, it is incredibly clear with hindsight that we should have created a detailed concept of operations as early as possible. Crucially, we missed the impact that our decision to rotate the satellite at 2000 km would have on the spacecraft configuration and scientific instrument. This led to major problems towards the end of the design process, which luckily could be solved. With a clear diagram of the concept of operations, however, we believe that this issue could have been found a lot sooner. This would have led to a more efficient design and reduced risks. It shows that stopping the current task, zooming out and considering the system as a whole can save a lot of time in the long run.
Another lesson was with the use of Comet and Excel. We tried to use a shared excel document so both members of the trajectory team were working from the same version. However, we kept facing consistent problems with syncing and as a result ended up with a messy local sheet with lots of repeated calculations and constant definitions. It would have likely been more efficient to keep separate local excels and share our calculations via Comet to avoid the sync issues. In the end, we cleaned up 1 local version and completed the pull-update-push cycle from one computer, and this worked for the purposes of this study. Realizing a better solution to the sync issues earlier would have sped up iteration and thus the rate of improvement.
The configuration subsystem is responsible for establishing the physical arrangement of all internal and external components used to build the spacecraft. The final configuration of our satellite was designed to satisfy the following requirements:
As discussed later in the Structures & Mechanisms section, the overall geometry was selected to be a rectangular prism. This choice was driven by the need for flat mounting surfaces for the instruments and subsystem components, optimal internal packing for the Xenon COPV tanks, and compatibility with the Ariane 62 rideshare fairing envelope. A cylindrical form was discarded as it would have complicated payload and internal component mounting and would have required active spacecraft rotation to keep the payload out of the sun vector.
The coordinate frame is defined as follows: the X axis points in the ram direction (velocity vector), the Z axis points toward Earth, and the +Y axis completes the right-hand frame.
From this geometry, the allocation of each face follows naturally from the mission constraints. The +Z face (top deck) hosts both science instruments, as it provides the stiffest and most thermally stable mounting surface and faces the ram direction when the spacecraft is in its nominal attitude. The −X face (rear side) is reserved for the main Hall Effect thruster. The ±Y lateral faces carry the antenna brackets at their lower edge, taking advantage of the permanent earth visibility guaranteed by the trajectory. The solar arrays, which could not be body-mounted on any face without interfering with instrument rotation or contaminating the science measurements, are deployed on an arm attached to the +X face (front side). This overall layout is the result of the successive trade-offs described in the sections below.
Two instrument placements were evaluated for the TOF-MS and the piezoelectric dust counter:
Option A – Instruments on separate faces:
Spreading the instruments across two faces avoids mutual obstruction but places the dust counter on the lateral side of the spacecraft, limiting its integration to the structural skin rather than the honeycomb deck.
Option B – Both instruments on the top deck:
Both instruments share the top deck (made in Al 2024-T3 honeycomb sandwich panel), which provides the stiffest, most thermally stable mounting surface on the spacecraft. The piezoelectric dust counter is placed at the front of the top deck, flush with the front edge, maximizing its forward sky exposure and fully satisfying its 180° FOV.
The TOF-MS is mounted centrally on the top deck, set further back. Because the TOF-MS body is significantly taller than the dust counter, its 45° aperture cone clears the dust counter entirely without any shadow obstruction, satisfying REQ-CONF-01 and REQ-CONF-03 simultaneously.

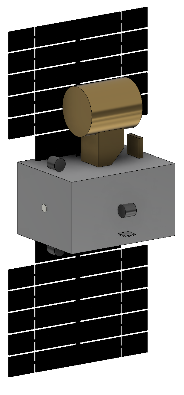

Option B was selected. Co-locating both instruments on the top deck also simplifies harness routing to the OBC and concentrates the payload thermal loads on a single well-characterized panel, reducing interface complexity with the thermal subsystem.
A critical operational consequence of this layout is the 180° spacecraft rotation required at the transition from Ascending to Descending Science. Because the TOF-MS must remain pointing in the direction of the spacecraft's motion, the entire spacecraft flips its thrust direction, and the instrument also rotates 180° to keep the same orientation.
The main Hall Effect thruster is placed on the –X face. The thruster plume is thus expelled away from both instrument apertures, satisfying REQ-CONF-04. The 12 cold-gas desaturation thrusters (AOCS) are distributed symmetrically around the spacecraft perimeter, at the mid-height of each lateral face, to provide clean torque arms without plume impingement on the science apertures.
Given the dusk–dawn SSO (OPS-03), the Sun illuminates the spacecraft nearly continuously from a direction approximately perpendicular to the velocity vector, making the lateral face the natural candidate for solar array mounting.
Initial design – lateral faces (+Y/−Y):
The first iteration placed the solar arrays mounted on the two lateral sides of the spacecraft. This is the conventional solution for dusk–dawn SSO and maximizes illuminated areas. However, two critical issues were identified during the design review:
Revised design – arm-mounted on +X face:

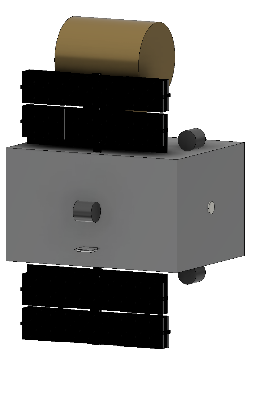

Following feedback received at the design presentation, the solar arrays were relocated to an arm extending from the +X face of the spacecraft. Panels are mounted on both faces of the arm, providing power during both ascent and descent phases while keeping the arrays clear of the top deck instrument apertures. This configuration moves the panels away from the lateral rotation envelope, resolving the flip maneuver interference, and physically separates them from the science instruments, eliminating the contamination risk.
Both the X-band payload downlink antenna and the S-band TT&C antenna are mounted on the bottom edge of the spacecraft lateral faces (+/- y faces), on a dedicated bracket structure. This positions both antennas permanently pointing toward Earth throughout the entire mission.
This placement is made possible by the trajectory design: the dusk–dawn SSO keeps the spacecraft above the Earth at all times, meaning a fixed earth-pointing antenna always has line of sight to a ground station without requiring any articulation or attitude-dependent pointing strategy. There is therefore no need to distribute the antennas across different faces to ensure coverage, as would be required in a more complex orbit.
This solution eliminates any risk of antenna shadowing by the solar arm or the spacecraft body during science operations and avoids the need for an omnidirectional antenna whose lower gain would reduce link margin.
All avionics (OBC, PCDU, reaction wheel electronics, communication units, ...) are mounted on internal brackets attached directly to the Al 6061-T6 L-stringers, within the radiation-shielded volume provided by the spacecraft itself. This eliminates the need for individual shielding vaults on each component.
The Star Tracker is mounted on a dedicated rigid platform anchored to the internal stringers, isolated from the outer skin to avoid thermal-gradient-induced misalignment (REQ-SM-04). It faces a clear sky cone on the Y lateral face. The Sun sensor and Earth sensor are mounted on the top deck honeycomb panel. The GNSS module is placed on the +Z face.
The final configuration places the main functional faces as follows :
| Face | Primary element |
|---|---|
| +X | Solar array arm |
| -X | Main HET thruster |
| +Y/-Y | Antennas |
| +Z | Payloads |
| -Z | Nothing |

The center of gravity was extracted directly from the CAD assembly on Fusion 360 with the correct masses applied to each component. The CoG is located at :
| Axis | CoG Offset from A |
|---|---|
| X | +566.1 mm |
| Y | +622.5 mm |
| Z | -413.1 mm |
The point A is the point located at the –X,-Y,-Z intersection (rear bottom right edge)
The total assembly mass in the CAD model is (238.0 kg) is in excellent agreement with the Systems Engineering dry mass subtotal of 238.38 kg (266.62 kg after the 10% system-level margin), confirming the consistency between the CAD model and the mass budget.
The inertia tensor at the centre of mass was extracted from the same CAD assembly:
| Component | Value [kg * m3] |
|---|---|
| Ixx | 159.1 |
| Iyy | 139.4 |
| Izz | 48.2 |
| Ixy = Iyx | 0.1 |
| Ixz = Izx | -1.26 |
| Iyz = Izy | 1.35 |
The cross-product terms are small relative to the principal moments, confirming that the coordinate frame is close to the principal axis frame. The lowest moment of inertia is about the Z-axis (48.2 kg·m²), making rotation around this axis the least demanding and it’s useful for the 180° flip maneuver at the ascending/descending science phase transition. These values were provided to the AOCS subsystem for reaction wheel sizing validation.
The launch vehicle selected is the Ariane 62, using the Multi Launch Service (MLS) MAS-H adapter. The MAS-H is a customizable platform accommodating 2 or more spacecraft side-by-side, with a total mass capacity of up to 5,000 kg and a platform diameter of up to Ø4300 mm (Ariane 6 MLS User's Manual, Issue 0 Revision 0).
Volume compliance: The spacecraft bus has a rectangular cross-section of 1224 × 924 mm (the structural height being 724 mm, oriented vertically along the launch axis). The circumscribed diagonal of this footprint is:
square root of the parenthesis.
In the 2-spacecraft MAS-H configuration (Fig. 3.1.1.d of the MLS manual), each spacecraft is allocated a cylindrical volume of Ø2130 mm, providing a margin of 597 mm over the 1533 mm diagonal. The spacecraft is therefore fully compliant with this envelope (REQ-CONF-05). The stowed height of the spacecraft is 1819 mm; per the MLS manual, the height of the allocated volume is not limited, so this is fully compliant.
Working as the Configuration engineer in this concurrent design exercise highlighted several important lessons:
The S&M subsystem is responsible for the integrity of the spacecraft from launch through end-of-life. The following requirements were derived from System Engineering requirements and Trajectory analysis:
A trade-off study was conducted between a cylindrical bus and a rectangular prism. While a cylinder offers superior mass-to-volume efficiency and was initially suggested to be used to rotate so the payload doesn’t face the sun, the Rectangular Prism (122.4×102.4×72.4 cm) was selected after eliminating the need for rotation of the whole spacecraft. This choice was driven by the configuration of the launch vehicle envelope and the need for flat mounting surfaces for the fixed solar arrays. The prism geometry also allowed for superior packing efficiency for the Xenon tank and the TOF-MS payload.

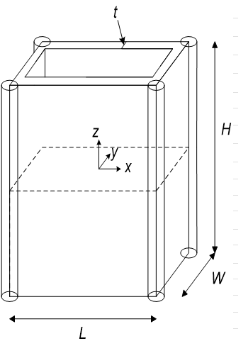

Figure 8 Simplified view of the spacecraft geometry, with the 4 corner stringers.
A "Battleship" structural strategy was adopted to solve the harsh radiation environment of the Circular Dusk-Dawn SSO.
To save mass, a direct-mounting strategy was used for the Earth, Sun, and GNSS sensors on the honeycomb top deck using potted inserts. However, for the Star Tracker, a dedicated rigid platform was justified. This platform anchors directly to the internal 6061-T6 stringers via space grade brackets, bypassing the 1.2 cm skin to ensure that thermal gradients in the Dusk-Dawn orbit do not misalign the optical axis.
The final design achieves a high degree of robustness while remaining well within the mass ceiling. By shifting the load-bearing requirements to the internal frame, the subsystem was able to accommodate the heavy shielding skin without breaking the mass budget.
Following the guidelines set by the Ariane 6 User’s Manual (Issue 2 Revision 0), the primary structure is designed to survive the most demanding flight phases. For an Ariane 62 launch, the mission must withstand a maximal compressive load of 3.1 g (occurring during ESR jettisoning) and a maximum traction stress of approximately 6.0 g (at ESR End of Flight).
The structural design utilizes a "Battleship" philosophy, leveraging a robust, thick-walled aluminum shell to serve as both the primary load path and a monolithic radiation shield for the 2,000 km SSO environment.
The primary axial loads are handled by four internal L-shaped stringers manufactured from Aluminum 6061-T6. This alloy was selected for its high strength-to-weight ratio and superior extrudability. By anchoring the structure to these stringers, the outer skin acts as a shear panel, preventing global buckling.
The critical buckling load (Pcrit) for these slender columns was verified using the Euler buckling formula:

Using a Young’s modulus (E) of 68.9 GPa and a total cross-sectional area of 276 cm² for the four-stringer assembly, the frame provides a safety factor well above the required 1.5, ensuring stability under the 156.14 kg maximum launch mass.
A significant design choice was the implementation of a 1.2 cm thick structural skin (t=1.2 cm) using Aluminum 7075-T6. This high-strength alloy (Yield=503 MPa) was chosen not only for its mechanical properties but also for its medium atomic number (Z=13), which effectively stops high-energy electrons without generating excessive secondary Bremsstrahlung radiation.
To verify the shielding effectiveness, the mission utilized the Vanderbilt University R-GENTIC tool to simulate the Total Ionizing Dose (TID) against varying thicknesses of Aluminum shielding.

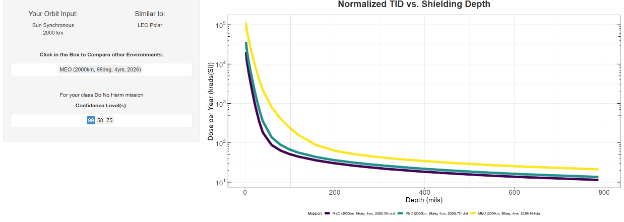

Figure 9 Verification of thickness sufficient against radiation.
As shown in the simulation results (Figure 9), the radiation dose follows an exponential decay relative to shielding thickness. The analysis highlights a critical "knee" in the curve between 10 mm and 12 mm.
By choosing this "Battleship" thickness, the structural skin mass (100.27 kg) effectively replaces the need for heavy, localized Tantalum or Tungsten vaults. This provides uniform radiation "safe-zone" for all internal payloads, including the Xenon tank and TOF-MS, while ensuring that secondary Bremsstrahlung radiation generation is kept to a minimum.
To withstand the permanent thermal gradients of the Dusk-Dawn SSO, a 40-layer space-grade MLI coating was applied. The top deck, which supports the TOF-MS payload, utilizes an Aluminum 2024-T3 Honeycomb sandwich panel. This maximizes the area moment of inertia to prevent bowing under payload weight while maintaining a low mass of 5.09 kg.
The total structural mass was calculated with a 20% margin to account for fasteners, potted inserts, and manufacturing tolerances.
| Component | Material | Mass [kg] |
|---|---|---|
| Skin Structure (1.2 cm thickness) | Aluminum 7075-T6 | 100.27 |
| Internal L-Stringers (x4) | Aluminum 6061-T6 | 14.904 |
| Top Deck (Honeycomb) | Al 2024-T3 | 5.089 |
| Bottom Deck | Aluminum 7075-T6 | 3.814 |
| Subsystem Platforms | Al 6061-T6 | 0.951 |
| Thermal Coatings (40-Layer MLI) | Space-Grade | 5.09 |
| Total Base Mass | 130.118 | |
| Final Mass (+20% Margin) | 156.141 |
Table 1 Structural mass per material and spacecraft subsystem
The resulting launch mass of 156.14 kg is well within the 172.2 kg system allocation, leaving a contingency of 16.06 kg for future design maturation.
Throughout the preliminary design phase as the Structures and Mechanisms Engineer I identified several technical and process-oriented lessons:
The primary purpose of the propulsion subsystem is to provide the controlled thrust necessary to alter and maintain the vehicle’s orbital trajectory. The subsystem's specific architecture and operational capabilities were driven by the following core requirements:
As established earlier in this report, the selected mission profile imposes an exceptionally high {Delta v} within a medium-duration lifecycle.
Operating as a primary payload subjects the spacecraft to volumetric and wet-mass limitations. Furthermore, the propulsion architecture must satisfy strict safety protocols regarding propellant toxicity, prevent physical contamination of the scientific payloads, and operate within a tightly coupled electrical power budget.
To reconcile these competing demands a series of trade-off analyses were conducted. The following sections detail the reasoning behind the final system architecture, evaluating the propulsion technology, power balancing, and hardware redundancy.
Considering this analysis, it was decided to move forward with the Electrical propulsion technology.
The Hall effect thruster was selected but there remained the question of the optimal propellant type. Most thrusters can function with Xenon, Argon and Krypton.
With that, the final configuration is a Xenon Hall Effect thruster-based system.
Usually, mission assurance is achieved through hardware redundancy. For this system, this would mean doubling each critical component. While the thruster itself is compact and light, the rest of the system is not. Complexifying and enlarging the whole system for the sake of redundancy did not feel adequate. Instead, it was decided to use a “single-string” architecture.
To mitigate the risk of lacking physical redundancy, the system will use exclusively Technology Readiness Level (TRL) 9 components. By using flight proven components, the statistical probability of hardware faults is minimized.
The financial and mass savings achieved by omitting hardware redundancy can be reallocated into other mission phases (assembly, integration and testing). Furthermore, rigorous test campaigns can ensure absolute reliability prior to launch.
As soon as the Hall Effect thruster technology was selected, a separate analysis had to start. Indeed, thanks to their PPU (Power Processing Unit) and PFC (Propellant Flow Controller), these thrusters are throttleable. An example of such performance ranges can be seen below in Figure 10.

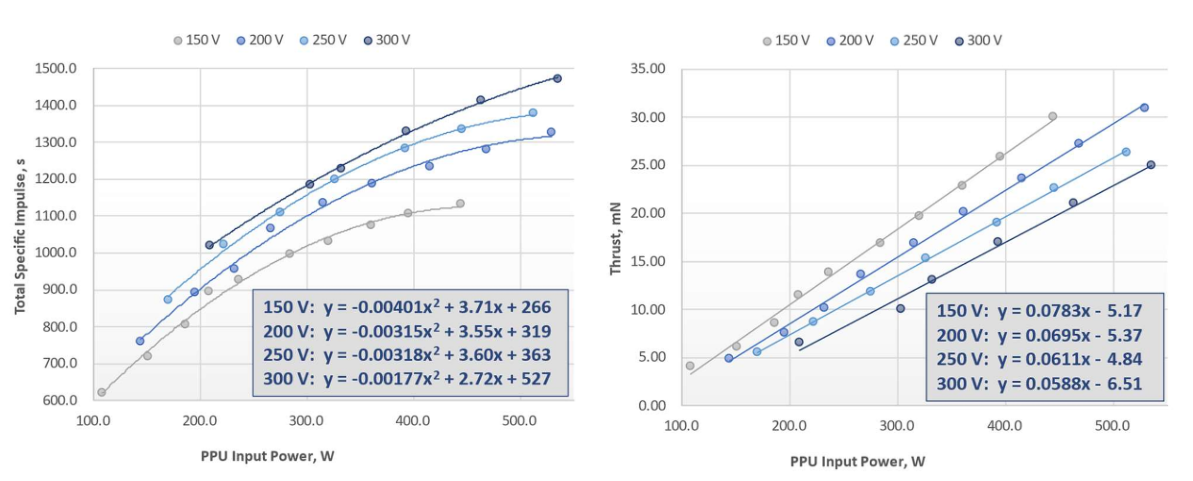

Figure 10: ExoTerra Halo (Xenon) Performance Graphs
The analysis looked at power draw, mission time and propellant mass in parallel. An optimization problem was solved to balance the PPU input power dictating the performance of the thruster while meeting the mission duration and propellant mass constraints.
The system was designed around the trade-offs and mission parameters described previously. Commercial off-the-shelf parts (COTS) were preferred, and most components are part of the same (ExoTerra Halo) system to ensure compatibility and performance. Said components include the thruster and propellant and power controllers (PPU, PFC, PMA). The final component to size is the tank to hold the propellant. As described when Xenon was chosen in 2.2., it is beneficial to store it under huge pressure conditions (~150bar). To do this, we use custom built COPVs (Composite Overwrapped Pressure Vessels) that have the added benefit of degrading well during reentry. It is here that the bulk of the iterations took place. The following computations happened in parallel until a satisfactory solution was found.
Now is a good time to point out that in the proposed design, the propellant is shared between Propulsion and AOCS. It was decided that the cold gas thrusters would use Xenon as well to reduce the overall complexity of the system.

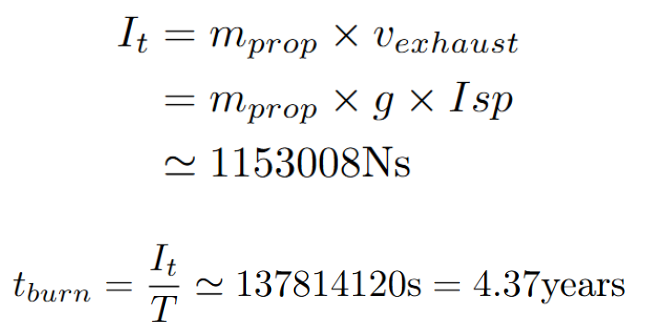

With this in mind, we start with the Tsiolkovsky rocket equation to find the propellant mass needed for our {Delta v}, total vehicle dry mass and chosen thruster performance values (see 3.4.).
![]()
The 17% margin was settled on at the end of the iteration process, once the tank volume was set.
Xenon being a non-perfect gas, the Wan der Waals equation was used to find the volume from the mass (we assumed 150bar of pressure and ambient temperature).

As it became clear that the propellant volume was converging towards 80L, the propellant margin reduced from an initial 20% to a more precise 17%.
The 80L value was key because COPV manufacturers generally sell 40/60/90/120L variants of their products. This means that to minimize the volume taken up by the tank while allowing for the 17% margin, a combination of two MT-Aerospace 40L Xenon COPVs was chosen.
The total thrusting time, driven by thruster performance (see Section 3.4) and propellant mass, was calculated to verify mission feasibility. Because the spacecraft has a strict 5-year lifespan, a transfer time exceeding this limit would mean the satellite degrades before it can fulfill its actual mission.

Preliminary research on the cost of 126kg of aerospace grade Xenon yielded a price per kg varying from 2100$ to 4800.
As explained in 2.4., the power budget is in direct link with the thruster performance in an electric propulsion system.
The optimal performance was found for a PPU input power of 253W yielding an {I_sp} of 1101s and a thrust of 8.3mN.
Adding other power draws from the PFC and PMA, the final peak power draw of 265W was found.

Figure 11: Overview of the ExoTerra Halo Propulsion System

Figure 12: Conceptual Render of the Assembled Propulsion System
The total dry mass of the propulsion system is seen in the table below.
| Component | Mass (kg) |
|---|---|
| 1 ExoTerra Halo thruster | 0.85 |
| 1 ExoTerra PPU | 2.38 |
| 1 ExoTerra PFC/PMA | 1.3 |
| 2 MT-Aerospace 40L Xenon COPVs | 12.6 |
| Plumbing | 2 |
| Total (+5% margin) | 20.1 |
Table 2: Overall Propulsion System Dry Mass
Throughout this preliminary design phase as the Propulsion engineer, I got to learn all about the technologies and components that make up a space propulsion system. I went in with no prior experience and got the chance to deep dive into technologies, systems, industry standards, and more. I now feel much more comfortable talking about the theory behind propulsion systems and their sizing. However, this is not the only thing I learned during this preliminary design phase:
The selection of AOCS components was driven by a balance between performance, reliability, system complexity, and resource constraints (mass, power, and volume).
Reaction wheels were chosen as the primary actuators due to their high pointing accuracy and continuous control capability, which is essential for maintaining payload alignment with the spacecraft velocity vector (REQ-AOCS-002). A four-wheel configuration (three orthogonal + one skewed) was selected to provide redundancy and fault tolerance. This increases mass compared to a three-wheel system but significantly improves reliability and mission robustness.
Cold gas thrusters were selected for reaction wheel desaturation because they provide reliable torque generation independent of the surrounding magnetic environment. Magnetorquers were considered as an alternative; however, their performance depends on the strength of the Earth’s magnetic field, which decreases with altitude and limits available control torque. Therefore, it was not suitable for our mission, which uses a Dawn–Dusk Sun-Synchronous Orbit (SSO). Since the spacecraft requires predictable and effective momentum unloading throughout the mission, cold gas thrusters were considered the more robust solution.
A set of 12 thrusters was selected to enable torque generation about all rotational axes and to ensure sufficient control authority during desaturation maneuvers. Although the use of thrusters introduces additional propellant mass, this approach offers higher maneuver reliability and shorter unloading times compared with magnetic control methods. Xenon was selected as the propellant because it can share storage infrastructure with the main propulsion system, reducing subsystem complexity, minimizing additional tankage requirements, and simplifying integration.
For attitude determination, a combination of sensors was selected to balance accuracy and resource usage. The star tracker provides high-precision attitude knowledge, while Sun and Earth sensors ensure compliance with avoidance requirements (REQ-AOCS-001). The GNSS module supports orbit determination, which is necessary for both navigation and sustainability requirements. However, only single units of each sensor were included, which reduces mass and power consumption but limits redundancy. This represents a trade-off between system robustness and resource constraints.
The final choice of sensors and actuators is presented in the table below, as well as the mass and power consumption of each component without margin. Margins of 5% were applied to most components to account for uncertainties, while a higher margin of 20% was used for the thrusters due to their lower technology readiness level. This reflects a conservative design approach to mitigate development risks.
| component | quantity | Mass [kg] (per unit / total) | Mean Power [W] (per unit / total) | Peak Power [W] (per unit / total) |
|---|---|---|---|---|
| RW | 4 | 1.0 / 4.0 | 3.0 / 12.0 | 15.6 / 62.4 |
| thruster | 12 | 0.18 / 2.16 | 2.0 / 24.0 | 2.0 / 24.0 |
| sun sensor | 1 | 0.037 | 0.015 | 0.15 |
| earth sensor | 1 | 0.4 | 4 | 4 |
| star tracker | 1 | 1.35 | 6,30 | 9 |
| GNSS module | 1 | 0.188 | 0.6 | 1 |
| total | - | 8.2 | 24.1 | 80.4 |
Table: mass and power of sensors and actuators (without margin)
There will be three types of maneuvers during operation:

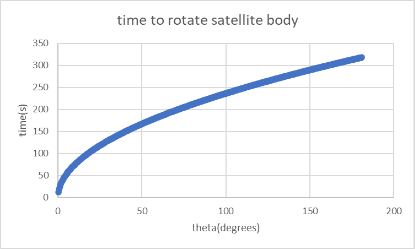

The time it takes to rotate the satellite around one of the axes, which is the most difficult case, is shown in Figure below. For example, to rotate 60 degrees will take around 180 seconds to do so. This is largely sufficient since the desired angular velocity during operation is approximately 4 degrees per minute.

Figure 13: The time it takes to rotate the satellite body
3.3. Sizing of reaction wheel:

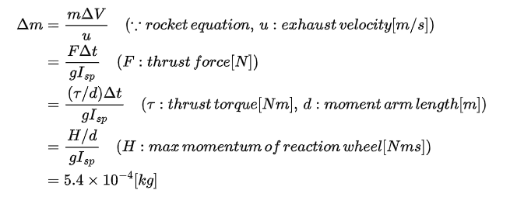

The sizing was done based on the maximum disturbance torque that the S/C might experience during operation. The calculations are as follows:

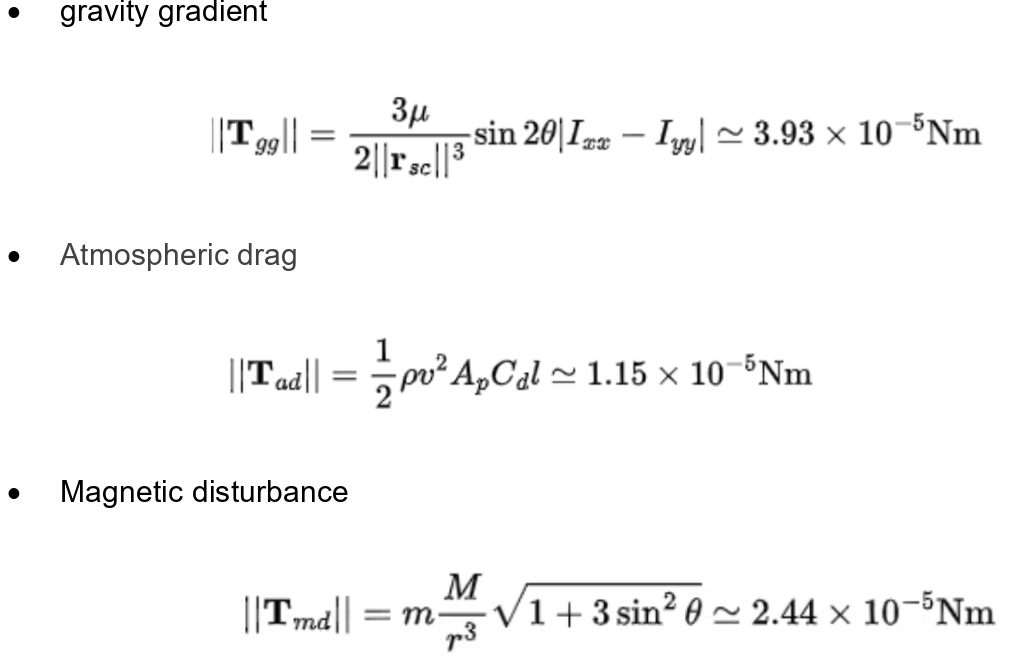

Based on the calculations above, the maximum disturbance torque is 7.5 10-5[Nm].
Assuming that the maximum torque is constantly being applied, the following can be calculated:
Propellant mass needed to desaturate one reaction wheel

The minimum time for one reaction wheel to saturate if the disturbance torque was applied to only one of the reaction wheels, the time it takes to saturate it is:

One of the key lessons I learned from this CDF was that all parameters should be quantified at the very beginning of the design process. I initially focused on deciding which components to use, without clearly defining the criteria for selecting them, and this ambiguity remained throughout the project. In addition, because I did not sufficiently quantify the design requirements, some choices—such as the wheel sizing—were not fully optimized, resulting in issues such as overly frequent desaturation intervals and unused mass allocation assigned by the systems engineer.
For AOCS specifically, I may not have included enough sensors. In previous CDFs, redundancy was achieved by using multiple sensors, but in my design, there was only one of each sensor. Although there was not enough time during this CDF to fully study controllability and related factors, I should have looked more carefully at past designs and applied those lessons to my own design.
The Command and Data Handling (C&DH) subsystem is driven by scientific data volume constraints and operational safety needs. The subsystem must fulfill the following mandatory requirements:
Data Management & Downlink:
Payload Interfaces:
Operational & Safety Functions:
To meet the requirements within the strict mass and power constraints of a small satellite, several architectural trade-offs were conducted:
Options: Using a single antenna for all communications vs. splitting the architecture into two dedicated antennas.
Options: Operating entirely in S-Band, entirely in X-Band, or a hybrid approach.
Based on the trade-offs and mission parameters, the subsystem was dimensioned using Commercial Off-The-Shelf (COTS) components. Here is an overview of the CDHS system:

The total data generated per orbit is heavily dominated by the payload (∼44.7 Mbits), with TT&C contributing a fraction (∼245 kbits). Applying a safety margin factor of 5, the required storage is 28 MB.
A standard COTS OBC with dual 8 GB Industrial MicroSD cards was selected to match REQ-CDHS-3. This provides a massive storage margin while consuming only 2.0 W of nominal continuous power.

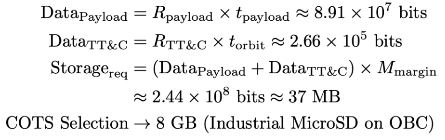

Here are the main equations used in data volume dimensioning:

Link Budget and Antenna Sizing
Transmission losses (Free Space Path Loss) were calculated based on the orbital altitude and the required data rates. The Link Budget dictated the required RF emission power:
The loss and dimensions of the antenna where derived from this equation:

Where {P_r, min} is the receiver sensitivity, {G_earth} is the ground antenna gain, {G_sat} is the satellite antenna gain, FSPL is the free space loss, and {L_m} is the loss margin.
The selection of the OBC and antennas directly sized the electrical and thermal budgets:
This last equation represents how the calculation of power budget was done:

Throughout the preliminary design phase I identified this lesson:
The Power subsystem’s purpose is to provide power to all other subsystems (and itself), including power generation and power distribution. This subsystem’s design was driven by the following requirements.
The power subsystem has three main objectives: power generation, storage, and transmission. Power generation is often referred to as to as “primary sources,” and 3 main options exist:
Given the mission’s expected duration of 5 years and a preliminary sizing of power consumption, with the help from Space Mission Analysis and Design, solar panels were chosen as the optimal primary source for this mission.
Power storage systems are referred to as “secondary sources.” The chosen secondary source for this mission is "secondary batteries” - designating batteries that can be recharged, as opposed to primary batteries.
With these “architecture” decisions made, sizing of the subsystem had to be performed.
To size the solar array and batteries, some important assumptions were made:
In addition to these assumptions, these decisions were made to “shape” the subsystem:
Then, the main drivers of the subsystem were:
The main formulas used in the sizing were as follows.
For the solar array:
All systems provided their power budgets in Watt-hours, forming the sum of power budgets. Recharge power was found as the amount of power (in watts) required for the maximum eclipse duration and then set as “recharge power” (in watt hours) the solar panels had to generate to recharge the batteries, in the minimum out of eclipse duration.
![]()
This formula finds the power density output [W/m2] at the end of life of a solar panel, using mission duration (5) and the yearly degradation of the solar panel’s specific technology (power density). The “1.2” factor is used to have a 20% margin and is the only place a 20% margin was accounted for.

From the total power budget and End of Life Power density Output, the solar panel area is easily found, and, from there, its mass as well.

For the batteries:
The battery capacity is the power (W) required by subsystems over an eclipse duration, plus the thermal power, as the thermal subsystem is only active during eclipses. Conversion Efficiency is taken into account as batteries do not convert energy 100% efficiently.

The battery energy at BOL must be found using the previously found battery capacity, degradation factor specific to the battery technology, and a depth of discharge that depends on eclipse time and battery technology.

From battery energy, the mass is found with ease using the specific technology’s specific energy.

Parameters
| Constants | |
|---|---|
| Solar Irradiance | 1360 |
| Mission Duration | 5 |
| Eclipse Time | 0.449944444 |
| Number of Cycles | 5000 |
| Orbit Time | 1.506666667 |
| Eclipse Fraction | 0.298635693 |
| Safety Factor | 2 |
| Inherent Degradation | 0.77 |
| Depth of Discharge | 0.3 |
| Number of Batteries | 3 |
| Bus Voltage | 36 |
| Thermal Peak Power | 75 |
| Thermal Power Usage | 33.74583333 |
Subsystem Power Inputs
| Subsystem | Peak Power [W] | Orbit Power [Wh] | Power [W] | Recharge Power [W] |
|---|---|---|---|---|
| CDH | 8.5 | 2.0 | 1.3 | - |
| AOCS | 80.3 | 24.0 | 15.9 | - |
| Power | - | - | - | 296.2 |
| Payload | 29 | 43.6 | 19.2 | |
| Propulsion | 264 | 397.7 | 264 | - |
| Total Power | 381.8 | 467.5 | 310.3 | 727.8 |
Solar Array Calculations
| Solar Cell Type | Silicon | Gallium Arsenide | Multijunction |
|---|---|---|---|
| Yearly Degradation | 0.037 | 0.027 | 0.005 |
| Efficiency [-] | 0.14 | 0.18 | 0.22 |
| Power density Output [W/m2] | 154.98 | 193.73 | 230.38 |
| Power density EOL [W/m2] | 128.02 | 168.51 | 224.68 |
| 20% Margin | 128.02 | 168.51 | 224.68 |
| Area [m2] | 4.73 | 3.59 | 2.69 |
| Density [kg/m2] | 12.5 | 2.5 | 1.25 |
| Weight [kg] | 59.22 | 8.99 | 3.37 |
Battery Calculations
With a battery capacity of 347.8Wh, found using the above formula and the subsystem power inputs:
| Solar Cell Type | Silicon | Gallium Arsenide | Multijunction |
|---|---|---|---|
| Battery Type | Li-ion | LiFePO4 | NiH2 |
| Battery Peak Power | 424.30 | 424.30 | 424.30 |
| EOL Retained Capacity | 0.8 | 0.8 | 0.85 |
| Depth of Discharge | 0.7 | 0.8 | 0.775 |
| Battery Energy (BOL) | 1242.08 | 1086.82 | 1055.89 |
| Nominal Cell Voltage | 3.6 | 3.2 | 1.2 |
| Number of Cells | 10 | 12 | 30 |
| Battery Capacity (Ah) | 34.50 | 28.30 | 29.33 |
| 2 String Capacity | 17.25 | 14.15 | 14.66 |
| Peak Current | 11.78 | 11.04 | 11.78 |
| Peak Current/String | 5.89 | 5.52 | 5.89 |
| C-Rate (1 Failed String) | 0.68 | 0.78 | 0.80 |
| C-Rate(Healthy) | 0.34 | 0.39 | 0.40 |
| Total Cells | 20 | 24 | 60 |
| Specific Energy (Wh/kg) | 180 | 205 | 60.6 |
| Mass [kg] | 6.90 | 5.30 | 17.42 |
With these outputs, using different technologies for both solar arrays and batteries, multijunction solar panels were chosen as the standard in space applications, even though they cost significantly more than Gallium Arsenide. For batteries, both Li-ion and LiFePO4 batteries could be chosen with an only 1.6kg difference, but Li-ion technology’s maturity for space applications was deemed preferable.
The final system outputs are:
Multi Junction Solar Panels
Li-Ion Batteries
Harnessing
For a total mass of 36.5kg.
The subsystem also includes power control, for this mission, Direct Energy Transfer was used as the shunt regulators can be used for EOL battery emptying, it is extremely efficient, and a quasi-regulated system functions for the spacecraft’s purposes.
The thermal subsystem is responsible for maintaining all spacecraft components and subsystems within their operational temperature limits throughout the mission lifecycle. In the space environment, where convective cooling is absent, the thermal subsystem must manage heat dissipation exclusively through radiation to space while simultaneously protecting sensitive equipment from extreme solar and planetary radiation. Effective thermal control is fundamental to mission success, as component degradation and structural integrity are all sensitive to temperature excursions beyond design limits.
Two distinct approaches were envisaged during the generation of the system :
Passive system
Description
Pros
Cons
Active system
Description
Pros
Cons
The passive architecture presented three potential drawbacks: limited dissipation capacity, poor heater efficiency due to radiator-side placement, and dependency on system-level coordination for shadow orientation and radiator sizing. However, none of these were binding in practice: total system dissipation was low, the structure provided adequate aluminum panel area, AOCS and trajectory design delivered thermally favorable orientations and orbits, and heater power consumption remained within power subsystem margins.
Given the program’s tight mass and cost constraints and already complex interface landscape, the passive system was selected.
To model the thermal behavior of the satellite we made the following assumptions :

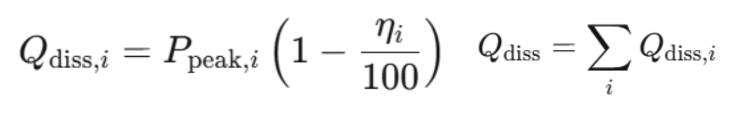

Dissipation is modelled as:

Earth view factor is approximated for a circular orbit:

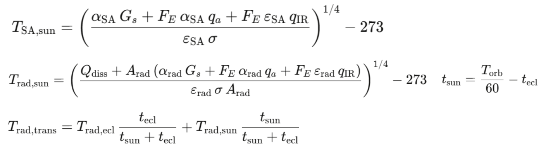

Solar array temperature, satellite sunlit temperature and eclipse transient temperature (in Celsius) are computed using the following formulas :

Where alpha and epsilon represent the absorptivity and emissivity of the body, Gs and q are environment heat flux and dissipation, Arad is the radiating area, t is duration.
As the thermal behavior of the satellite is constrained by its environment and its embedded assemblies, eclipse duration and the total dissipation were the main drivers, directly impacting the radiator specifications and overall sizing.
The thermal subsystem uses a hub-and spoke architecture where the hub is the radiator (an aluminum structure panel located at the satellite’s bottom) with its heater, and the spokes are the heat pipes going from the radiator / heater combo to each dissipating assembly of the satellite. The solar arrays are treated as independent hubs.

Figure 14 Simplified view of the radiator / heater + heatpipes layout

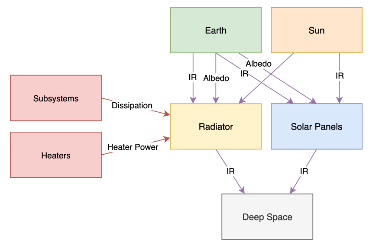

Radiation predominates, coming from the earth (Albedo + IR) and the sun (IR). Dissipation coming from the other subsystems is transported to the radiator by the heatpipes and expelled through radiation to deep space. A similar pattern is visible solar panel-side.

Figure 15 Thermal model diagram
Inputs

Outputs

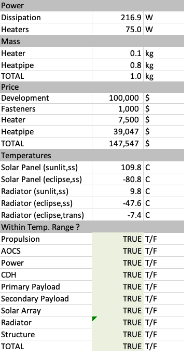

The table above summarizes the thermal subsystem performance. In the worst-case scenario, the radiator can dissipate 216.9W of power and the heater produce about 75W during eclipse, keeping the satellite’s subsystems within their respective temperature ranges (cf. “Within Temp Range ? section).
A quick price analysis was run as a bonus, but it should be discarded, as very preliminary and not accounting for system-level developments.
The satellite’s temperature oscillates between -7.4°C and 47.6°C, while the solar panels have a broader temperature range, between -80.8°C and 109.8°C.
Given this, with the latest inputs the thermal subsystem is compliant with its four technical requirements.
Launcher Selection:
A trade-off was conducted to select the most suitable and sustainable launch vehicle, driven by the customer's requirement to use a European launcher.

Figure 16 Launcher Choice Diagram
End of Life:
Several EoL disposal strategies were evaluated to safely remove the spacecraft from its orbit:
The D4D strategy was retained as the balance between mass budget impact and system simplicity.
Demisability Assessment:
During atmospheric re-entry, a spacecraft typically experiences peak heating at altitudes between 70 and 80 km, where aerodynamic deceleration generates surface temperatures exceeding 1600°C. Components are considered demisable if their melting point falls well below this threshold and their geometry promotes early fragmentation and ablation.
Since the majority of the spacecraft is aluminum, the heat of atmospheric re-entry will melt the structure away. The only minor concern lies with the steel rotors inside the reaction wheels due to their high melting point. However, because each rotor weighs less than 1 kg, any surviving fragments would be too small to pose a risk to people on Earth, complying with the ESA's 15-Joule safety threshold.

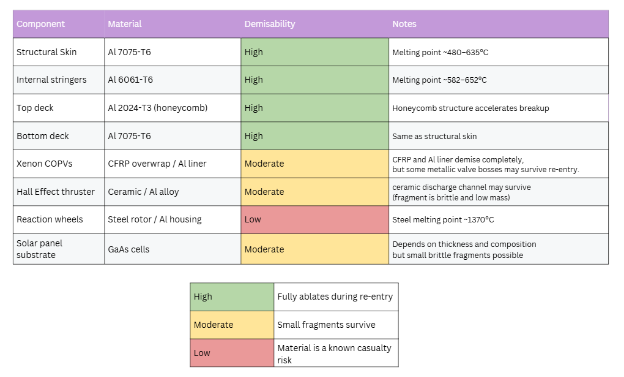

Figure 17 Material Demisability Table
Collision risk:
Although computational constraints prevented the use of the ESA MASTER software, the collision probability was analytically approximated using the following formula:

Where:
The spatial flux was approximated using the MASTER reference populate from the ESA Space Environment 2025:

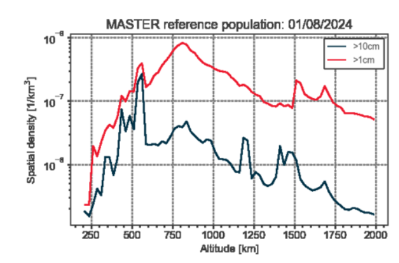

Figure 18 ESA Space Environment 2025 : Density of space objects larger than 10 and 1 cm (including active satellites)
As shown in the results table, the worst-case scenario occurs at transit at 800 km (known as a congested region). Despite this, the collision risk remains low and well within safety margins.

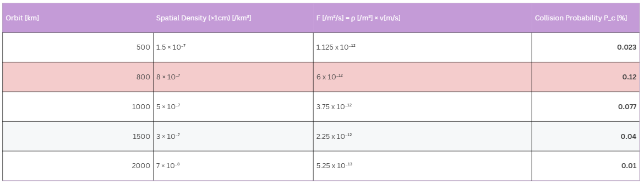

Figure 19 Collision Probability Table
Three system-level trade-offs locked the design envelope before the subsystems could converge: orbit architecture, launcher selection, and the budgeting strategy itself.
Two architectures were carried into the trade: a retrograde Molniya orbit and a circular dusk–dawn SSO. From an SE perspective the decision was driven by the system-level cost of each option rather than by science alone. The Molniya orbit roughly doubled the ΔV budget (driving propellant mass and tank volume), pushed the wet mass beyond any rideshare envelope, and demanded distributed radiation hardening to cope with repeated Van Allen transits, while the dusk–dawn SSO sat naturally inside the European rideshare manifest and kept the radiation and thermal environment benign for every other subsystem. The SSO was selected; the orbital mechanics, altitude profile, and ΔV breakdown are detailed in the Trajectory Analysis section (SCI-12, REQ-26).
REQ-02 restricts the mission to a European launcher, leaving Vega-C and Ariane 62 (rideshare or dedicated) as the realistic candidates. Once the bottom-up dry mass settled in the 250–270 kg range — well below either dedicated capacity — the SE-level trade collapsed to a cost-and-schedule comparison: a dedicated Vega-C slot (≈ 60–80 M€) versus an Ariane 62 shared SSO slot priced at Arianespace's indicative ~10 k€/kg rideshare tariff (≈ 5–7 M€ all in). Ariane 62 rideshare was selected, freeing roughly 60 M€ that flows directly into the cost reserve and the 35 M€ payload pre-allocation. The flight-environment, sustainability, and deployment-orbit case for the choice is detailed in the Space Sustainability section.
Two budgeting philosophies were on the table. A pure top-down allocation distributes a fixed mission mass to subsystems based on heritage fractions, forcing the design to converge against a hard envelope; a pure bottom-up roll-up sums first-principle subsystem estimates and lets the platform mass emerge, at the risk of running away from any launcher-compatible target. STARDUST adopted a hybrid strategy. The first iteration was top-down, anchored on the IBEX (Interstellar Boundary Explorer) heritage mission — a NASA Small Explorer whose compact in-situ particle instrument suite closely matches the STARDUST TOF-MS plus piezo dust counter, making its per-subsystem mass fractions a credible first reference. This produced Target 1: 90.9 kg dry, 125.6 kg of xenon, 216.6 kg wet — small enough for a dedicated small-launcher slot in the spirit of IBEX itself. Once each discipline produced its first bottom-up estimate the dry mass climbed to 238.4 kg, dominated by the “Battleship” radiation-shielded primary structure (156 kg) that absorbed every other subsystem's vault and by a redundant power chain (32 kg). Forcing the design back to 90 kg would have meant abandoning the Battleship or restoring localized radiation hardening across every subsystem; neither was acceptable in Phase A. The allocation was therefore re-opened: the launcher trade was revisited (REQ-02) and Ariane 62 in shared configuration was retained, lifting the rideshare envelope to roughly 300 kg per passenger to dusk–dawn SSO. A second target (Target 2: 266.6 kg allowable dry mass) was then negotiated jointly with Trajectory and Propulsion against a hard physical constraint — the maximum xenon volume that two 40 L commercial COPVs can hold (125.6 kg of Xe) caps the achievable Δv, and back-solving the rocket equation against the 5-year mission Δv yields 266.6 kg as the largest dry mass the propulsion subsystem can fly. The hybrid converged: top-down envelopes from the launcher and the propellant volume, bottom-up roll-up from the subsystems, with a uniform 10 % system-level margin on top of subsystem contingencies in line with ESA Phase 0/A practice.
The system-level budgets (mass, power, cost) close out the Systems Engineering outputs and form the contractual interface between SE and the subsystem teams.
The mass budget was the central system-level convergence variable and went through three distinct allocation regimes, summarized in Figure 20 and Figure 21. The target dry mass (Figure 20) opens at ~90 kg, set by the IBEX-heritage top-down allocation and a small-launcher first cut. It then jumps to 300 kg once the launcher trade settled on Ariane 62 rideshare, whose shared SSO capacity comfortably accommodates several hundred kilograms per passenger and gave the subsystems room to close their bottom-up estimates without wholesale re-design. A final downward step to ~266 kg occurs when the propulsion bottom-up closes: a pair of 40 L commercial xenon COPVs caps the propellant at 125.6 kg, and back-solving the rocket equation against the 5-year Δv budget yields 266.6 kg as the maximum dry mass the propulsion subsystem can fly. The total spacecraft mass evolution (Figure 21) shows the matching bottom-up trajectory: it crosses 118 kg in the first roll-up (top-down stub, payload and propulsion only), rises to ~210 kg as the Battleship structure is sized against radiation, climbs through the 235–260 kg corridor as the redundant power chain, harness, and AOCS converge, and finally stabilises around 260–266 kg under the Target 2 envelope. Two subsystem decisions dominate the bottom-up roll-up. Structures and mechanisms grow to 156 kg (≈ 65 % of dry mass) once the Battleship strategy of consolidating all radiation shielding into a single thick aluminium primary structure is adopted, eliminating localised vaults in CDH, propulsion electronics, and AOCS; the power chain then settles around 31.7 kg (≈ 13 %), with the harness alone (~23.6 kg) being the second-largest single contributor on the spacecraft, a direct consequence of the redundant TT&C and payload power buses required for a 5-year science mission. Conversely, the budget actively shaped the subsystem designs. The 266.6 kg dry-mass cap drove propulsion to a single Hall-effect thruster sized at the lowest power class compatible with the Δv (~265 W PPU), eliminated the option of titanium structural elements in favour of an Al 7075-T6 / 6061-T6 / honeycomb 2024-T3 stack, constrained AOCS to a low-mass reaction-wheel set without dedicated thrusters, and forced thermal control to a passive-only architecture. The final allocation (Table 20) closes at 262.2 kg dry / 387.9 kg wet with 10 % system-level margin on top of subsystem contingencies, leaving 4.4 kg of margin against the Target 2 envelope and a wet mass that is compatible with both Vega-C and Ariane 62 rideshare manifests.

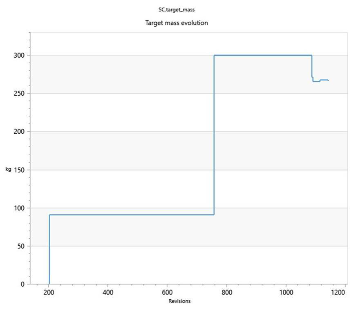

Figure 20 Target dry-mass evolution across the system-level negotiations: Target 1 at ~90 kg (IBEX-heritage top-down, small-launcher first cut), 300 kg envelope after the move to Ariane 62 rideshare, and final Target 2 at 266.6 kg set by the 40 L COPV xenon-volume cap.

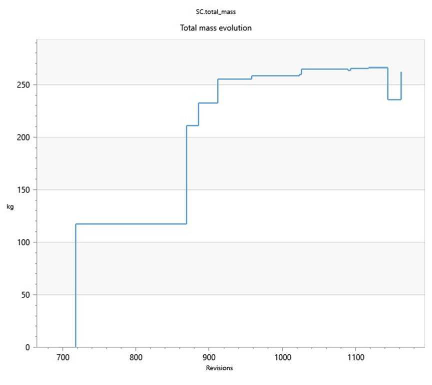

Figure 21 Total spacecraft mass evolution from the bottom-up roll-up: first stub at ~118 kg, jump to ~210 kg with the Battleship structure, convergence through the 235–260 kg corridor as the power chain, harness, and AOCS close, and stabilisation in the 260–266 kg band.
| Subsystem | Mass [kg] | Share of dry [%] |
|---|---|---|
| Payload (TOF-MS + dust counter) | 20 | 8.4 |
| AOCS | 8.18 | 3.4 |
| Structures and Mechanisms | 156.14 | 65.5 |
| Propulsion (dry) | 20.09 | 8.4 |
| Power (incl. harness) | 31.74 | 13.3 |
| Thermal | 1.03 | 0.4 |
| C&DH / Communications | 1.2 | 0.5 |
| Dry mass subtotal | 238.38 | 100 |
| System-level margin (10%) | 23.84 | — |
| Total dry mass (with margin) | 262.22 | — |
| Propellant (Xe + cold gas) | 125.64 | — |
| Total wet mass | 387.85 | — |
Table 2 Final mass budget per subsystem, with system-level margin.

The power chain is sized for worst-case eclipse with all nominal loads active: the solar arrays (2.25 m² of multi-junction GaAs) deliver 225 W at end-of-life and must recharge the battery during the shortest daylight pass of the dusk–dawn SSO. The battery (LiFePO₄, 12s2p, 28 Ah, 1100 Wh BOL) absorbs the peak load and covers the full eclipse duration. The propulsion string (PPU, ~265 W) is the dominant consumer during the spiral phases; during those arcs the payloads may be inhibited to protect the bus from plasma contamination (REQ-33). At least 20% margin on generated EOL power is preserved (REQ-46).
The 170 M€ cap (REQ-05) and the 35 M€ payload pre-allocation (REQ-08) bound the budget. The remaining lines are built bottom-up from the 387.85 kg wet mass (Table 2), the Ariane 62 rideshare tariff (REQ-02) and parametric CERs calibrated on SMEX-class heritage (IBEX, DESTINY+).
Launch is sized on the Arianespace indicative rideshare rate of ~10 k€/kg to SSO: 387.85 kg × 10 k€/kg ≈ 3.9 M€ raw, rising to 5 – 7 M€ once the integration premium, insurance and campaign support are added — well inside the 60 – 80 M€ envelope that a Vega-C dedicated slot would have required.
The nominal lines sum to 150 M€, leaving a 20 M€ system-level cost reserve (≈ 13 %) consistent with ESA Phase-A guidance for an SMEX-class mission. The allocation is summarised in Table 3.
| Cost line | Nominal [M€] | Range [M€] | Share [%] |
|---|---|---|---|
| Payload (fixed, REQ-08) | 35 | 35 | 20.6 |
| Launch services (Ariane 62 rideshare) | 6 | 5 – 7 | 3.5 |
| Spacecraft platform (hardware) | 73 | 68 – 78 | 42.9 |
| Xenon propellant (125.6 kg) | 0.5 | 0.3 – 0.6 | 0.3 |
| AIT and environmental campaign | 7 | 6 – 8 | 4.1 |
| Ground segment (capex + 5 yr service) | 8 | 7 – 9 | 4.7 |
| Flight operations (commissioning + 5 yr) | 8.5 | 7 – 10 | 5 |
| Project management, SE, PA, docs | 12 | 10 – 14 | 7.1 |
| Nominal sub-total | 150 | — | 88.2 |
| System-level cost reserve (≈ 13 %) | 20 | — | 11.8 |
| Mission cost cap (REQ-05) | 170 | — | 100 |
Table 3 Phase-A cost decomposition for STARDUST; ranges are the residual uncertainty absorbed by the reserve.
The dominant sensitivity is the dry mass: any slip beyond ~550 kg wet would push STARDUST off the rideshare tariff and towards a 15 – 20 M€ dedicated small-launcher slot. The risk is tracked as PM-01.
Acting as the Systems Engineer for STARDUST highlighted a handful of lessons that transcend the individual subsystems:
For general lessons learned about concurrent engineering, go to the useful_tips page (accessible to eSpace staff only).
Subsystems' lessons learnt are directly added in the sections above.
This study carried out a Phase 0/A concurrent design of STARDUST, a mission to characterize the flux, chemical composition, and orbital distribution of sub-micrometer cosmic dust and anthropogenic debris at altitudes between 500 and 2,000 km. The work was conducted over a series of engineering sessions within the ENG-411 Concurrent Engineering course at EPFL, following the ESA Concurrent Design Facility methodology.
The study converged on a technically coherent solution. A 387.9 kg wet-mass spacecraft carrying a TOF-MS impact ionization instrument and a piezoelectric dust counter is inserted by Ariane 62 rideshare into a 500 km dusk–dawn Sun-synchronous orbit. A Xenon Hall Effect thruster system raises the orbit in a continuous low-thrust spiral to 2,000 km over approximately 2.75 years, before descending symmetrically for the remainder of the five-year science mission. The circular SSO was selected over a retrograde Molniya option primarily on cost and power grounds: the permanent solar illumination eliminates deep-discharge battery cycling, and the rideshare-compatible insertion avoids the expense of a dedicated launcher. A “Battleship” structural philosophy: a 1.2 cm aluminium 7075-T6 skin acting as a monolithic radiation vault, resolves the challenging MEO radiation environment without individual shielding vaults on each subsystem, at the cost of a structurally dominant dry mass. The total mission cost is estimated at 150 M€ against a 170 M€ cap, with a 20 M€ system-level reserve.
All major subsystem interfaces converged within the study timeline. The mass budget closed at 262.2 kg dry (versus a 266.6 kg allowable), the power chain is sized for worst-case eclipse with 20% end-of-life margin, and the spacecraft complies with ESA debris mitigation guidelines through a Design-for-Demise end-of-life strategy targeting natural re-entry from 300 km within five years.
Several cross-cutting themes emerged consistently across all subsystems and reflected the nature of concurrent engineering itself.
The single most important structural insight was that every design decision is a system-level decision. Accepting the Battleship skin mass more than doubled the structural allocation but eliminated radiation vaults from every other subsystem, collapsing integration risk across the board. Relocating the solar arrays from the lateral faces to a front-facing arm resolved a payload contamination risk and an instrument flip-maneuver conflict simultaneously, but only because Configuration, AOCS, and Propulsion were iterating together in real time. The 180° spacecraft rotation required at the ascending-to-descending science transition, an operationally critical maneuver, was identified late because the concept of operations had not been diagrammed early enough. This caused a cascade of late design changes that consumed time all teams could not afford. A clear, shared ConOps diagram from day one would have surfaced the issue in the first session.
The role of a single authoritative source of truth, the COMET parameter catalogue, proved its value every time a subsystem updated a value outside it, as a divergence appeared within one or two iterations. The flip side was equally instructive: COMET’s poor ergonomics meant that teams who did not invest time in correctly pushing and subscribing to variables found themselves working from stale local sheets. The tool is only as consistent as the discipline with which teams use it.
Concurrent engineering also exposed how much of spacecraft design is negotiation rather than optimization. The Systems Engineer’s core task was translating subsystem updates into budget consequences and feeding them back as constraints that every other team could design against. The first mass allocation (90.9 kg dry) was a hypothesis that became untenable once the shielding strategy was chosen; reopening it transparently, rather than forcing unrealistic subsystem targets, allowed the design to converge honestly. Similarly, the propulsion engineer ultimately set the dry mass ceiling, not the systems engineer, because the propellant tank volume dictated the allowable structural envelope. These reversals are normal and healthy in a concurrent process; what matters is that they are communicated quickly and documented clearly.
At the process level, the study reinforced that Phase 0/A is fundamentally about convergence, not accuracy. Every number in this report is an estimate, and the goal was to arrive at estimates that are mutually consistent and physically plausible, not to pre-empt Phase B analysis. Where assumptions were made, trajectory distribution of dust particles, station-keeping budget derived from literature, thermal model reduced to two lumped masses, the subsections document them explicitly so that a follow-on study knows exactly where to invest modelling effort first.
Looking ahead, the three areas warranting the most attention in a Phase B study are the delta-V budget (combining plane-change and altitude-change maneuvers into simultaneous burns is expected to reduce the 3,641 m/s total significantly), the AOCS sensor suite (redundancy was not fully addressed in this phase), and the mass budget margin on the structural subsystem, which absorbs the bulk of the spacecraft mass and leaves limited headroom for design maturation.
STARDUST emerges from this study as a feasible and scientifically compelling mission. The concurrent design process demonstrated both its strengths, speed of iteration, forced interface discipline, early identification of cross-cutting trades, and its demands: the need for a shared frame of reference, honest re-baselining when early allocations prove unreachable, and the discipline to zoom out and consider the system as a whole before optimizing any single subsystem.
We would like to thank Mathieu Udriot and Marnix Verkammen for their supervision, Stephan Hellmich, Andrew Price and Abdullah Feyzi for the continuous feedback and Veerle Sterken for the client’s needs discussions.
